Page 14 - 2022 - Q4 - Minerva in Focus
P. 14

SAFETY & SECURITY  Safety Digest:

         Mooring deck accident

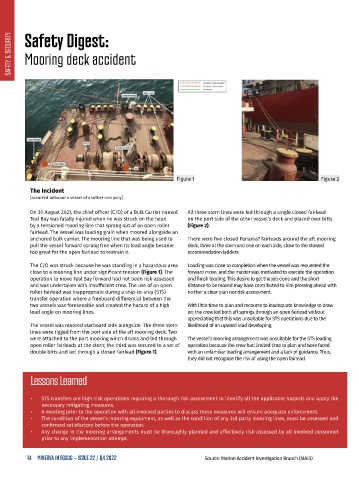

                                                            Figure 1                                       Figure 2
           The Incident
           [occurred onboard a vessel of another company]


           On 30 August 2021, the chief officer (C/O) of a Bulk Carrier named   All three stern lines were led through a single closed fairlead
           Teal Bay was fatally injured when he was struck on the head   on the port side of the other vessel’s deck and placed over bitts
           by a tensioned mooring line that sprang out of an open roller   (Figure 2).
           fairlead. The vessel was loading grain when moored alongside an
           anchored bulk carrier. The mooring line that was being used to   There were five closed Panama7 fairleads around the aft mooring
           pull the vessel forward sprang free when its lead angle became   deck, three at the stern and one on each side, close to the stowed
           too great for the open fairlead to restrain it.     accommodation ladders.
           The C/O was struck because he was standing in a hazardous area   Loading was close to completion when the vessel was requested the
           close to a mooring line under significant tension (Figure 1). The   forward move, and the master was motivated to execute the operation
           operation to move Teal Bay forward had not been risk-assessed   and finish loading. This desire to get the job done and the short
           and was undertaken with insufficient crew. The use of an open   distance to be moved may have contributed to him pressing ahead with
           roller fairlead was inappropriate during a ship-to-ship (STS)   neither a clear plan nor risk assessment.
           transfer operation where a freeboard differential between the
           two vessels was foreseeable and created the hazard of a high   With little time to plan and recourse to inadequate knowledge to draw
           lead angle on mooring lines.                        on, the crew led both aft springs through an open fairlead without
                                                               appreciating that this was unsuitable for STS operations due to the
           The vessel was moored starboard side alongside. The three stern   likelihood of an upward lead developing.
           lines were rigged from the port side of the aft mooring deck. Two
           were attached to the port mooring winch drums and led through   The vessel’s mooring arrangement was unsuitable for the STS loading
           open roller fairleads at the stern; the third was secured to a set of   operation because the crew had limited time to plan and were faced
           double bitts and led through a closed fairlead (Figure 1).   with an unfamiliar loading arrangement and a lack of guidance. Thus,
                                                               they did not recognise the risk of using the open fairlead.

           Lessons Learned



           •   STS transfers are high-risk operations requiring a thorough risk assessment to identify all the applicable hazards and apply the
               necessary mitigating measures.
           •   A meeting prior to the operation with all involved parties to discuss these measures will ensure adequate enforcement.
           •   The condition of the vessel’s mooring equipment, as well as the condition of any 3rd party mooring lines, must be assessed and
               confirmed satisfactory before the operation.
           •   Any change in the mooring arrangements must be thoroughly planned and effectively risk-assessed by all involved personnel
               prior to any implementation attempt.


          14 MINERVA IN FOCUS – ISSUE 22 / Q4 2022                   Source: Marine Accident Investigation Branch (MAIB)
